What is office reinstatement in Singapore?
Office reinstatement means returning a leased office to its original condition at the end of the lease, as set out in your tenancy agreement. It typically covers removing partitions, flooring and fittings, and making good ceilings and M&E.
You sign a new lease, plan the move, book the movers. Then the landlord reminds you about reinstatement, and suddenly your deposit feels very fragile.
This guide explains office reinstatement from a contractor point of view, so tenants in Singapore know what landlords expect and where surprise bills usually come from.
what landlords expect at office handover
Most Singapore landlords expect you to return the office to its original condition
at handover.
That usually means removing partitions and built ins, bringing ceilings, lights and M&E back to the landlord’s base layout, patching and painting, removing cabling, and delivering a clean, safe unit that the building can lease again without extra work.

1. What office reinstatement
really means in Singapore
In most commercial leases you will see a reinstatement or make good clause. In plain language, it means:
- Put the office back to how it was when you received it
- Follow the building’s renovation and handover rules
- Finish everything before the lease expiry date
That original condition
can mean:
- Bare shell Concrete floor, basic ceiling (or none), basic lighting, no partitions.
- Partially fitted Some landlord items like ceiling grid, lights, aircon, pantry shell, basic flooring.
Your lease and the original handover photos should define which one applies. If this is vague, you have a high risk of arguments and extra charges at the end.
2. What landlords actually look for at handover
Seen from the landlord and building management side, a good reinstatement handover has three parts.
A. Correct physical condition
Typical expectations:
- All tenant partitions removed unless landlord agrees to keep them
- Floors brought back to the agreed condition
- Ceilings and light fittings consistent with base building
- Aircon diffusers, return grilles and ducts made good
- Fire sprinklers and smoke detectors arranged to suit the open layout
- No loose wires, broken tiles or visible damage
The goal is not to make the office luxury
. The goal is to make it neutral and leasable.
B. Compliance with building and authority rules
Building management will also check that:
- Fire protection layout remains compliant
- Exit signs and emergency lighting work as required
- Any hacking or structural works had proper approval
- Wet works did not affect neighbours or common spaces
This is where an office fit out specialist like MD Interior helps. They already live with MCST rules, BCA and SCDF related requirements from their renovation projects.
C. Cleanliness and presentation
Most handover guides mention:
- Floors swept and mopped
- Rubbish, pallets and loose fixtures removed
- Paint touch ups done so the space looks tidy
- No abandoned furniture, cables or signage
If the landlord has to call their own contractor to clean or patch, they will often charge you using their rates, not the market price you could have negotiated.

3. Typical reinstatement scope from a contractor point of view
From a reinstatement contractor’s view, a normal office handover in Singapore includes several work groups.
Partitions and doors
- Remove all tenant partitions in gypsum, glass or composite panels
- Remove tenant doors, frames and locks that did not belong to landlord
- Make good floor and ceiling where these partitions were fixed
Flooring
- Uplift carpet tiles, vinyl or raised flooring installed by tenant
- Patch holes, grind adhesive and make surface ready for new tenant
- In some leases, reinstall original tiles or landlord approved finish
Ceilings and lights
- Restore base ceiling grid height and pattern if it was changed
- Remove feature ceilings that do not match landlord standards
- Reinstall landlord type light fittings and arrange spacing evenly
Mechanical and Electrical (M&E)
This is where many surprise items and costs hide.
You may need to:
- Remove extra aircon units, fan coils or diffusers added during fit out
- Adjust ducting to match open layout
- Move sprinklers so there are no
shadow
areas - Relocate smoke detectors and speakers
- Remove extra distribution boards or trunking added by tenant
- Disconnect and remove data points, trunking, floor boxes and server room cabling that are not part of landlord base fit out
Carpentry, fixtures and signage
- Remove built in cabinets, reception counters, meeting room joinery
- Remove tenant logos and external signage
- Patch walls and bulkheads where signage was fixed
Patching, painting and cleaning
- Patch all fixing holes and chased sections
- Repaint walls in landlord colour, often plain light tone
- Final cleaning before joint inspection
MD Interior already handles this mix in office renovation work, so their team understands how to reverse a fit out without leaving hidden defects.

4. Reinstatement process step by step
Here is how a well run reinstatement project usually flows from the contractor side.
Step 1: Lease review and handover guide
- Read the reinstatement clause together with the tenant
- Request the building’s renovation and handover handbook
- Compare current office condition with original handover drawings and photos
Good contractors will highlight grey areas early, such as:
- Whether landlord wants ceiling and lights fully back to base condition
- Whether they accept some partitions to remain
- How strict they are about paint and floor condition
Step 2: Site walk and photo record
Contractor walks the unit with tenant, sometimes with building management.
They will:
- List everything that differs from base condition
- Take photos of feature areas and services
- Check fire protection layout, risers and plant room connections
This becomes the reference list for both scope and pricing.
Step 3: Detailed quotation
A proper reinstatement quotation should:
- Break down major work groups (partition removal, M&E, ceiling, flooring, cleaning)
- Mention what is included, excluded and optional
- State if PE endorsement, after hours work or hoarding is needed
This is where you can compare MD Interior against two or three other office reinstatement providers. You want clarity, not only the lowest number.
Step 4: Approvals and permits
Before work starts, your contractor should help to:
- Submit reinstatement plans to landlord or building management
- Apply for renovation permits and book lift and loading bay slots
- Confirm allowed noisy work hours and weekend rules
- Arrange any required Professional Engineer endorsements
MD Interior already explains permit handling in their article on office renovation permits in Singapore. The same logic applies to reinstatement.

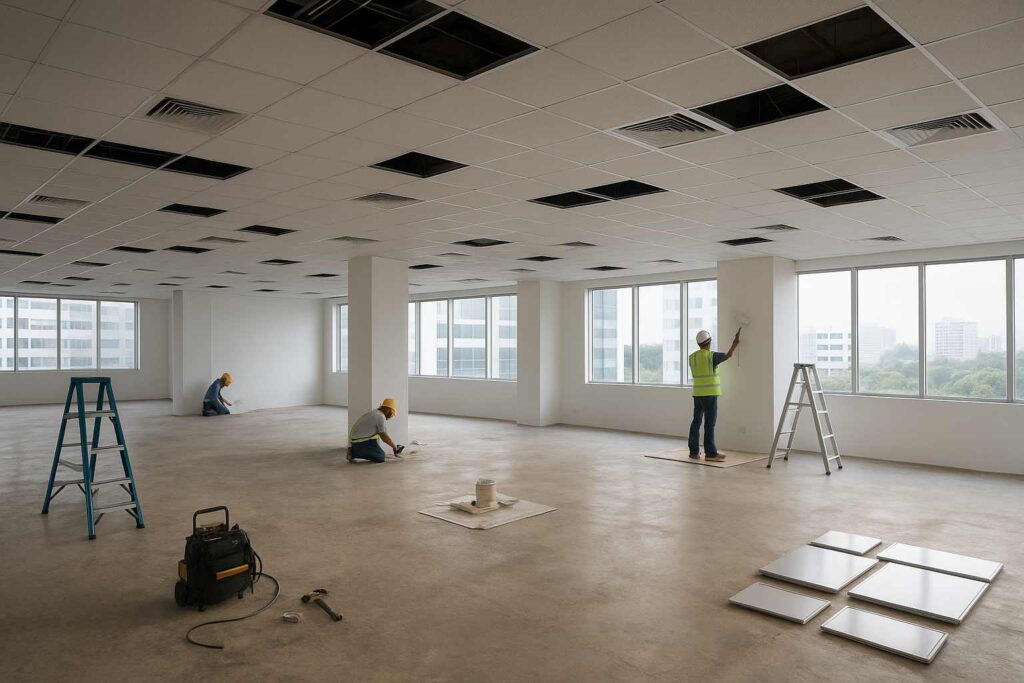

Step 5: Execution on site
On site, the sequence usually runs:
- Protection of common areas
- Dismantling and demolition
- M&E reinstatement and ceiling works
- Patching, painting and floor works
- Cleaning and touch ups
Disposal must follow building rules and NEA guidelines. Tenants are normally responsible for all debris from their reinstatement.
Step 6: Joint inspection and touch ups
Finally, landlord or building management will walk the unit with you.
- Any defects are entered in a handover list
- Contractor returns to clear these items
- Once everyone agrees, the landlord signs off and releases the unit
If the unit is not ready at lease end, landlords can charge extra rent or call their own contractor and bill you. A clear process and timeline avoids that.

5. How to avoid surprise reinstatement bills
From a contractor viewpoint, most nasty surprises come from the same few habits.
Start early
- Begin talking about reinstatement three to six months before lease expiry
- Get reinstatement scope in writing from landlord
- Ask for photos of a
bare
orbase
unit in the same building
Know what you are restoring to
Clarify if you need to hand back:
- Bare shell
- Partially fitted
- Something in between
Ask for:
- Original fit out drawings if landlord has them
- List of landlord items that must remain (for example FCUs, base lights)
Take control of M&E scope
Tenants often under estimate:
- Cost of moving sprinklers and detectors
- Work needed to restore aircon layout
- Time needed for testing and commissioning
Insist that your contractor spells this out in the quote and in the plan.
Protect your deposit with documentation
Before work starts:
- Take dated photos of existing cracks, stains or defects
- Keep copies of all approvals and inspection reports
- Record each joint inspection outcome in email
This helps if there is a later claim that something was not reinstated
or damaged by tenant
.
6. Cost and timeline factors in office reinstatement
Every office is different, so any number here is only a ballpark. From what contractors in Singapore share publicly, costs are usually driven by:
- Size of the office in square feet
- Number of meeting rooms and built in items
- Amount of glass and custom carpentry
- Complexity of M&E changes made during fit out
- Whether work is limited to nights or weekends
- How strict the building is about noise and dust
Timelines often look like this:
- Small office under about 1 000 sq ft About one working week if permits and access are smooth
- Medium office around 1 000 to 3 000 sq ft One to two weeks of active site work
- Larger spaces above 3 000 sq ft Several weeks, especially if there are many rooms and heavy M&E
The important point for tenants. You cannot start two days before lease end and expect a clean handover.
7. How MD Interior can help tenants with reinstatement
MD Interior focuses on commercial interior design and office renovation in Singapore. That makes them a natural partner when you need to undo a fit out and give the unit back.
Practical advantages of working with a design and build team like MD Interior:
- One point of contact Same team can handle both your new office fit out and reinstatement of the old unit.
- Experience with building rules Familiar with MCST and landlord requirements in business parks and CBD buildings.
- Space planning insight They understand how your existing layout is built, so they know the quickest safe way to strip it back.
- Cost conscious approach They can separate
must do
reinstatement items fromnice to have
requests that landlords may not actually require, which helps reduce wasted spend. - Future fit out ready They can align reinstatement works with your move timeline so you avoid paying double rent for too long.
You can link key phrases in this article to relevant MD Interior pages, for example:
- Link
office renovation in Singapore
to https://mdinterior.com.sg/office-renovation/ - Link
interior renovation services for offices
to https://mdinterior.com.sg/services/ - Link
office renovation permits in Singapore
to their permits guidehttps://mdinterior.com.sg/office-renovation-permits-your-singapore-guide/

Final quick checklist for tenants
Before you sign a new lease or confirm your move out date, run through this short list.
- Read your reinstatement clause and ask questions early
- Get landlord’s handover guide and sample photos of a base unit
- Do a joint site walk and agree on scope in writing
- Shortlist two or three reinstatement contractors, including MD Interior
- Confirm timeline, noisy work hours and building permits
- Keep photo records and inspection notes to protect your deposit
Handled this way, office reinstatement becomes a planned project instead of an emergency. You leave the space on good terms and move into your new office without nasty surprises from the old one.
