How Long Does an Office Renovation Take in Singapore?

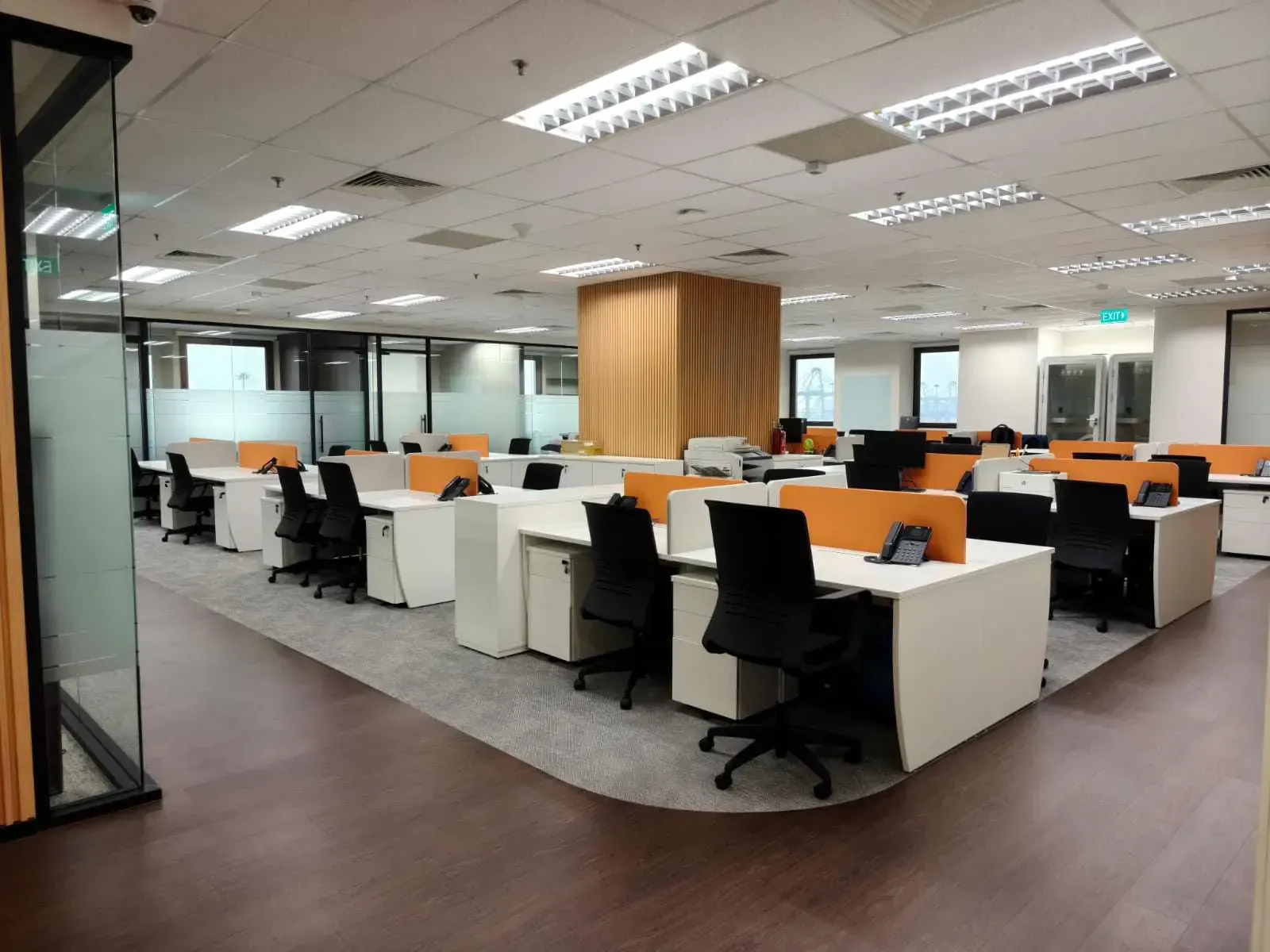

Open-plan workstations after an office renovation in Singapore by Metadesign Interior

How long does an office renovation take in Singapore?

Most office renovations in Singapore take around 6 to 12 weeks from design sign-off to handover, or about 8 to 16 weeks if you count the design stage. Larger floors can run 16 to 24 weeks or more. On-site work is only part of that. Design, landlord approvals and ordering materials often take as long as the build itself.

Most business owners ask about the build time. What matters more is the whole project, because your lease date and move-in date both hang on it.

This guide breaks an office renovation into five phases, shows where time usually goes, and flags the approvals that add weeks if nobody plans for them. If you are planning a move or a refit, it will help you set a realistic date before you sign a lease or a contract.

The five phases of an office renovation

Quick Answer: An office renovation in Singapore runs through five phases: brief and design, approvals, ordering, on-site works, and handover. A small office typically takes about 8 to 12 weeks end to end, a mid-size office 12 to 16 weeks, and a large office 16 to 24 weeks or more. BCA, SCDF or JTC submissions add time, because approvals must be in place before work starts.

Here is how the time typically splits across a Singapore office fit-out.

PhaseWhat happensTypical duration
1. Brief and designSite survey, space planning, layout, material and finish selection2 to 4 weeks
2. ApprovalsLandlord or MCST consent, building permit to work, BCA/SCDF submissions if triggered2 to 6 weeks
3. Ordering and fabricationGlass partitions, carpentry, acoustic panels, lighting, furniture3 to 6 weeks
4. On-site worksHacking, M&E, partitions, ceiling, flooring, carpentry, painting4 to 10 weeks, depending on size
5. Testing and handoverM&E testing, defects walk, final clean, fire safety certification if needed1 to 2 weeks

Phases 2 and 3 can overlap. While the approvals are with the building, joinery and partitions can already be in production. That overlap is one of the easiest ways to take weeks off a project.

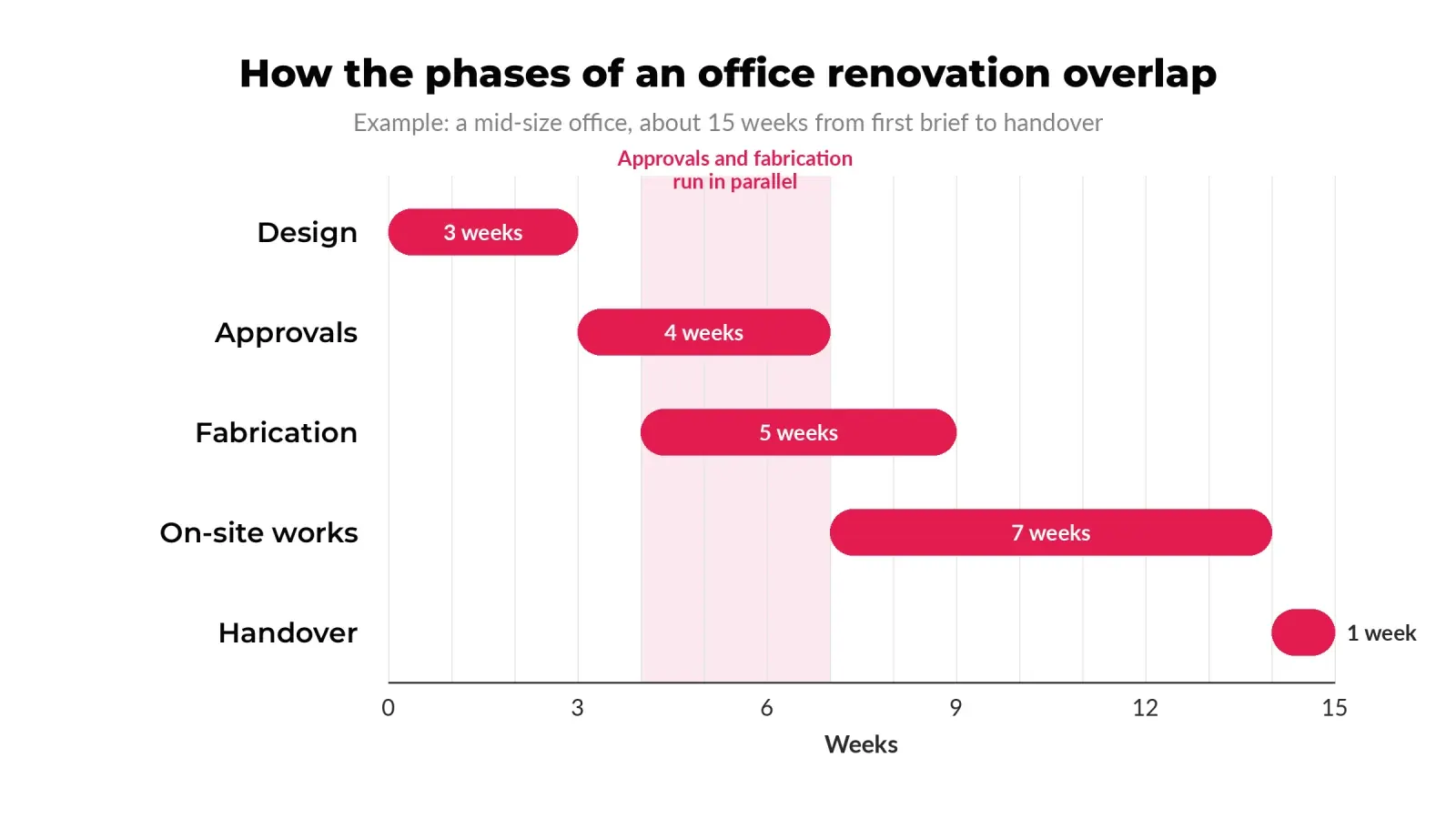

Office renovation timeline in Singapore showing design, approvals, fabrication, on-site works and handover, with approvals and fabrication overlapping
Example of a mid-size office: running approvals and fabrication in parallel keeps the whole project to about 15 weeks.

How office size changes the timeline

Floor area matters, but scope matters more. A small office with three glass meeting rooms and a new pantry can take longer than a bigger open-plan floor with carpet and paint.

As a typical guide:

  • Small office, under 2,000 sq ft: about 8 to 12 weeks end to end
  • Mid-size office, 2,000 to 5,000 sq ft: about 12 to 16 weeks
  • Large office or full floor, over 5,000 sq ft: about 16 to 24 weeks or more

The biggest swing factors are M&E changes (air-con redistribution, extra power and data points), the number of enclosed rooms, and custom carpentry. A light refresh on an existing layout sits at the short end. A full fit-out of a bare unit sits at the long end.

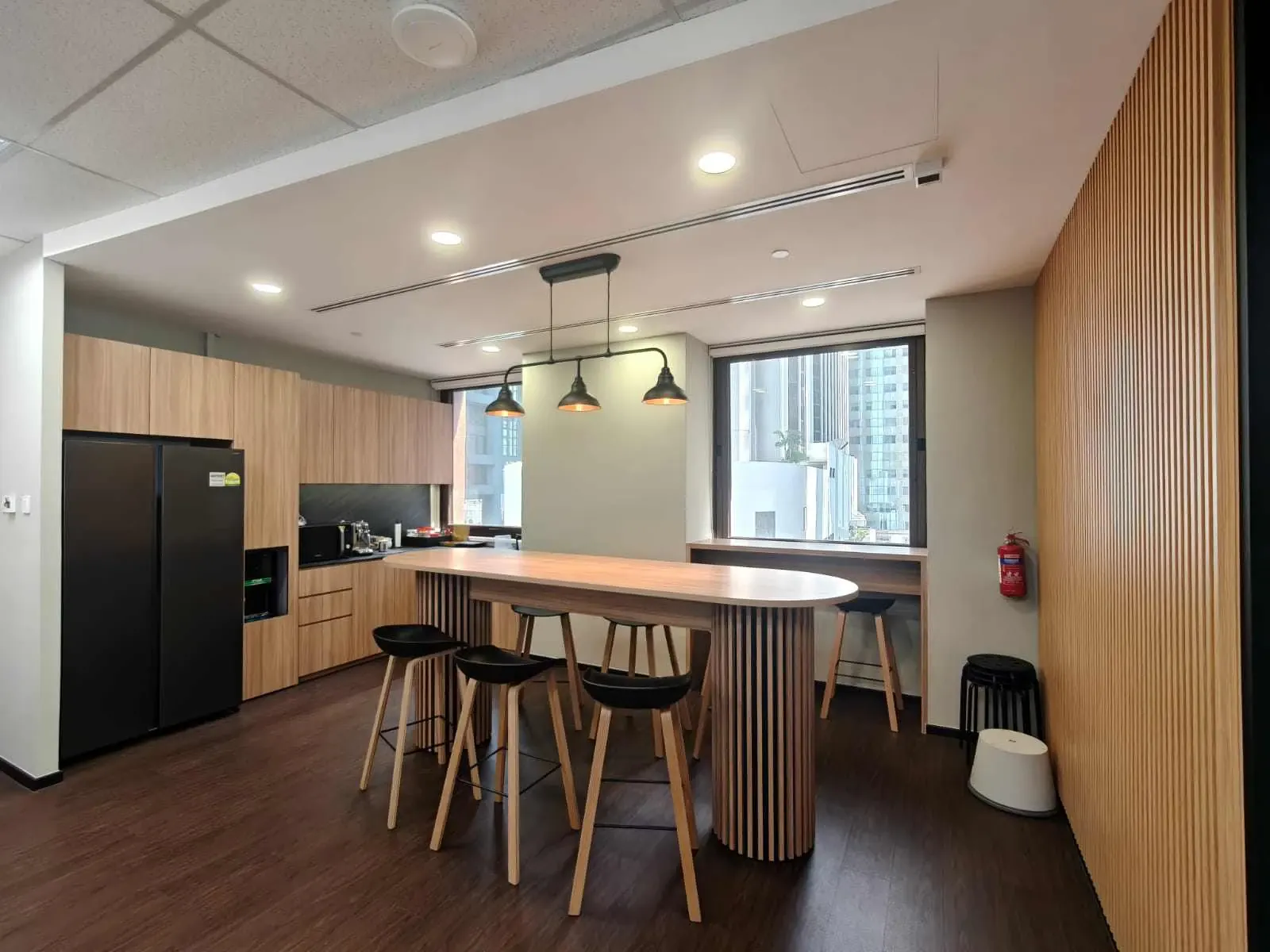

Office pantry with custom timber carpentry and island counter, part of an office fit-out in Singapore
A pantry like this adds plumbing, electrical points and custom carpentry, which all add time to the schedule.

The approvals that add weeks

Most delays do not happen on site. They happen before a single wall comes down, when a submission is late, incomplete or missing.

Landlord and building management consent. Every office renovation needs the landlord’s written approval before work starts. In strata-titled buildings, works that touch common property also need the MCST’s approval. Building management will then ask for a permit to work, usually with drawings, a method statement, a risk assessment and insurance. Build this into your plan from day one.

JTC buildings. If your office is in a JTC property, JTC requires its plan consent for all fitting-out works, temporary or permanent, before any other authority approval. JTC notes that the facility management team’s review of the permit-to-work application typically takes less than 20 days.

BCA, for structural work. Cosmetic works generally do not need BCA plan approval. Hacking structural walls, cutting new openings in slabs or adding loads usually does, and a Qualified Person must submit the plans. Once the structural plan is approved, BCA’s stated processing time for the permit to carry out structural works is 7 days.

SCDF, for fire safety works. Moving sprinklers, changing escape routes or altering fire-rated walls can trigger SCDF plan approval. After completion, the premises may also need a Fire Safety Certificate before you can occupy them. SCDF says it responds to certificate applications within 3 working days, and if the application is picked for inspection, that normally happens within 10 days.

Our office renovation permits guide covers which works trigger which approval in more detail.

What slows an office renovation down

In our experience, these are the usual culprits:

  1. Late design changes. Moving a meeting room after partitions are ordered means re-drawing, re-quoting and re-ordering.
  2. Long-lead items. Glass partitions and custom carpentry typically need 3 to 6 weeks to fabricate, and imported furniture can take longer. Order them as soon as the design is signed off.
  3. Building work-hour rules. Many CBD towers only allow noisy works like hacking after office hours or on weekends. That stretches the on-site phase.
  4. Unclear handover condition. A quote priced for a fitted unit will not match a bare slab. Confirm the base condition of the unit before planning the schedule.
  5. Acoustic fixes after move-in. Adding sound insulation to a finished meeting room means reopening ceilings and walls. Planning acoustics at design stage is far faster than fixing noise complaints later.

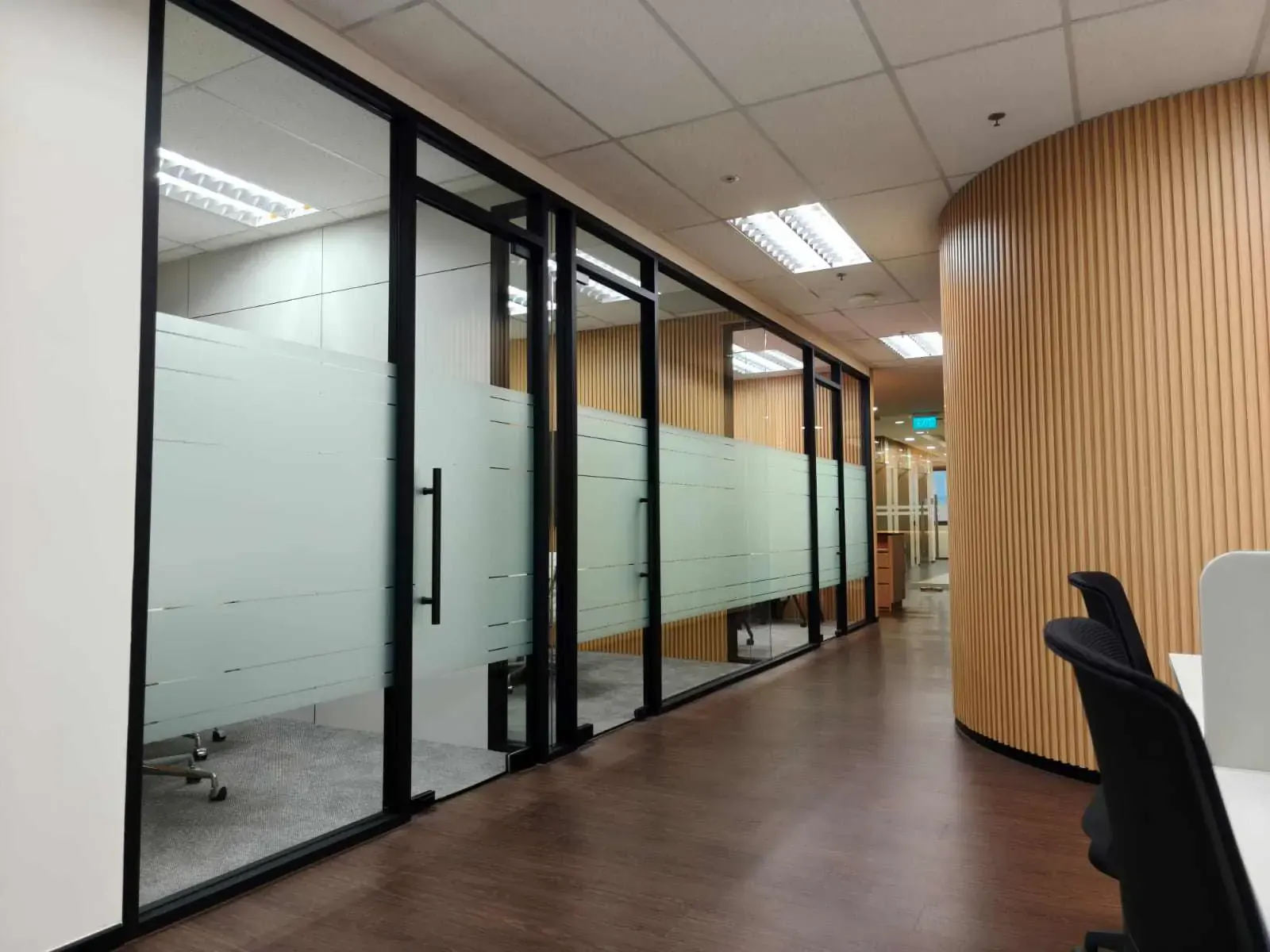

Framed glass partitions and a curved timber slat wall in a Singapore office renovation
Framed glass partitions and curved timber slat walls are made to measure, so they need to be ordered as soon as the design is signed off.

That last point is one we push early on every project. Quiet meeting rooms and balanced open-plan zones depend on partition height, ceiling details and door seals, which are all decided in phase 1.

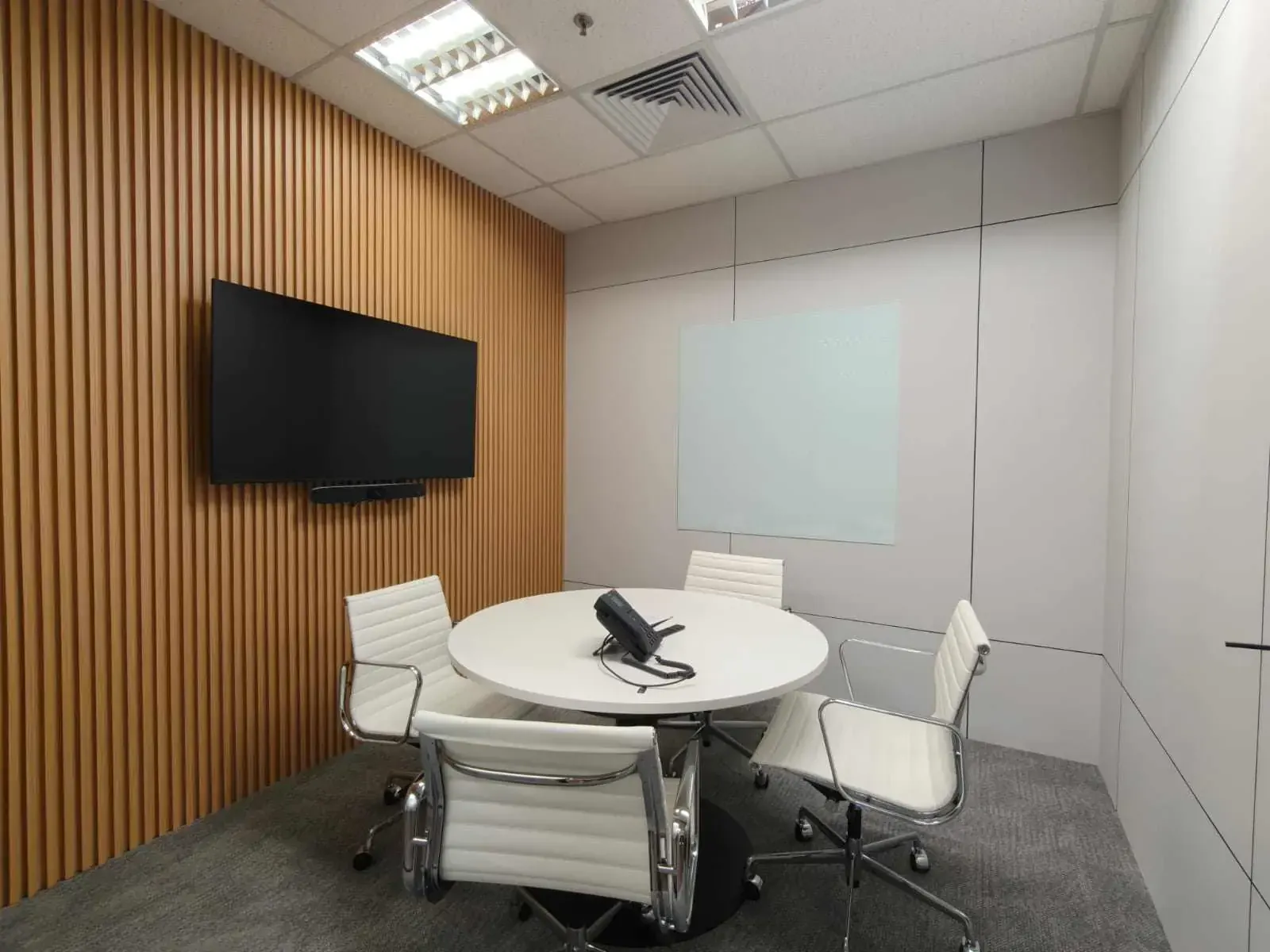

Small meeting room with timber slat wall and wall panels after an office renovation in Singapore
An enclosed meeting room with a timber slat feature wall and wall panels. Choices like these shape how the room sounds, so they are made at design stage.

How to keep your office renovation on schedule

A few habits make a real difference:

  • Start design early. Get your layout moving once your lease is signed, so approvals can run while the unit is being handed over.
  • Freeze the design early. Agree the layout, finishes and meeting room count before ordering starts.
  • Ask for a written schedule. A contractor should show you each phase, key dates, and what they need from you. At Metadesign Interior, you get a detailed schedule after the first consultation.
  • Check your fit-out period. Many landlords give a rent-free fit-out period. Ask for it during lease talks and match it to a realistic schedule.
  • Use one team for design and build. A single team handling design, approvals and construction avoids hand-off gaps between a designer and a separate contractor.

You can see how we run each stage on our how we work page.

Frequently Asked Questions

How long does an office fit-out take in Singapore?

A full fit-out of a bare unit usually takes longer than renovating an existing office, because everything from ceiling to M&E is built from scratch. Most projects land between 8 and 16 weeks, with large floors taking 16 to 24 weeks or more.

Can an office be renovated while staff keep working?

Often, yes. The work is split into zones, and noisy works run after hours or on weekends. This adds time to the overall schedule, but it avoids moving your team out. Metadesign Interior plans each project to keep disruption to your business low.

Do I need BCA approval to renovate my office?

Only for certain works. Cosmetic changes generally do not need BCA plan approval, but structural works such as hacking load-bearing walls do. A Qualified Person should confirm this before work starts, and landlord approval is needed either way.

How long does SCDF take to issue a Fire Safety Certificate?

SCDF states it responds within 3 working days of an application, with any inspection normally carried out within 10 days. The application can only be made after all fire safety works are complete.

When should I start planning an office renovation?

Start at least 3 to 6 months before your target move-in date. That leaves time for design, approvals and ordering before the on-site works begin.

Plan your office renovation timeline with us

Most of an office renovation’s timeline is decided before anyone picks up a tool. Sort out landlord, BCA and SCDF requirements early and the build itself rarely becomes the problem.

If you have a lease date or move-in date in mind, talk to Metadesign Interior about our office renovation services or contact us for a timeline built around your space.

What Our Clients Say

Creating Inspiring Spaces, One Project at a Time

"We entrusted MetaDesign Interior with our office renovation, and they exceeded all expectations. The smart space planning and modern design have not only improved productivity but also created a vibrant working environment."

Office Renovation — Marcus Tan,Tech Solutions Pte Ltd

"MetaDesign Interior helped us maximize our office space in the CBD. Their space planning strategies allowed us to add more workstations while keeping the environment open and comfortable. Truly impressive!"

Space Planning — Hui Ling, Creative Director, Imagine Studios

"The custom furniture by MetaDesign Interior has brought our workspace to life. Every piece was carefully crafted and tailored to our exact needs, blending seamlessly with our office design."

Custom Furniture Design — Aaron Lim, Partner, Lim & Wong LLP
enquiry form
